09.06.2020 - demolition has been completed.
17.12.2020 - drainage installation finalised and preparation for slab formwork underway.
21.01.2021 - slab pouring has been completed.
04.02.2021 - brickwork has started, termite barrier installed and frame work underway.
18.02.2021 - framework in progress and party wall close to completion.
23.02.2021 - ground floor frame complete, first-floor frame and steel frame in progress.
04.03.2021 - posi struts installation complete and first-floor structure in progress.
18.03.2021 - preparing first-floor frame for the installation of the roof trusses.
01.04.2021 - frameworks complete, fascia, gutter installation and roof cover to follow.
15.04.2021 - frame inspection complete and roof cover in progress.
29.04.2021 - roof complete, windows and sliding doors installation in progress.
13.05.2021 - all windows installed, with external cladding in progress.

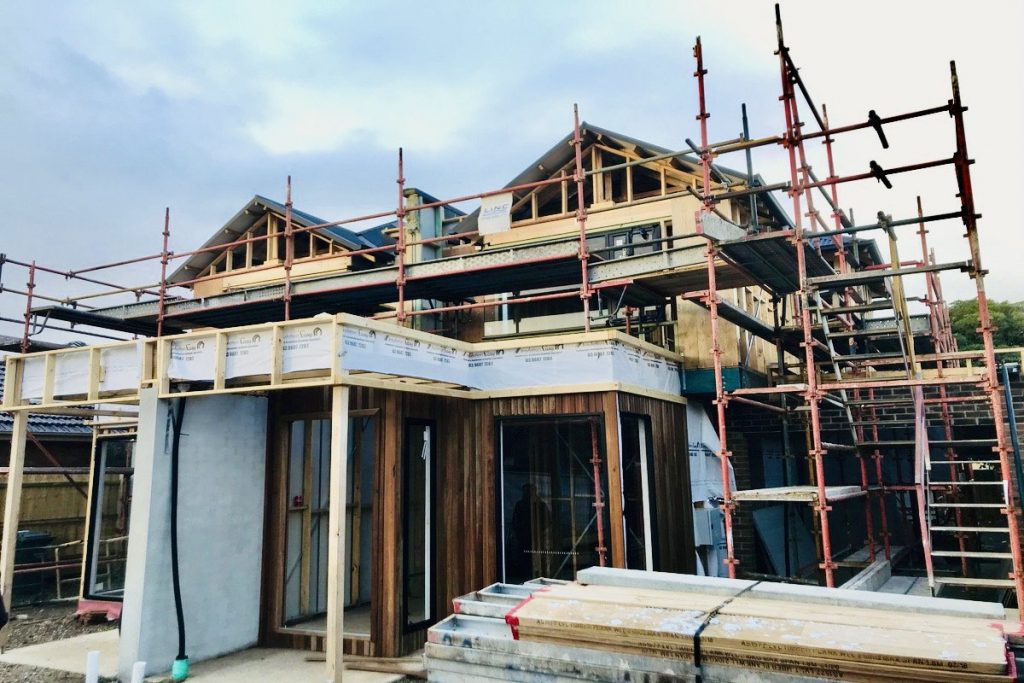

27.05.2021 - first-floor cladding in progress, moving towards completion of lockup stage.
10.06.2021 - external cladding almost complete, render and base coat in progress.
09.06.2020 - demolition has been completed.
08.07.2021 - lockup almost complete, duct heating installation and rough-in in progress.
22.07.2021 - plumbing and aircon rough-in complete, electrical rough-in in progress.
06.08.2021 - rough-in complete and insulation in progress.
02.09.2021 - plastering in progress.
16.09.2021 - plastering and stairway installation complete, waterproofing in progress.
30.09.2021 - site has been closed for two weeks (COVID shutdown) back onsite next week.
14.10.2021 - fixing stage almost complete, joinery installation to be finalised soon.
28.10.2021 - tiling in progress & first coat of internal painting started.
11.11.2021 - tilling almost complete.
25.11.2021 - internal painting is in progress, to be finalised soon.
09.11.2021 - tiling and grouting are almost complete.
09.11.2021 - tiling and grouting are almost complete.
20.01.2022 - builder will resume activities on site next week, completing rough-in and preparing for plastering.
03.02.2022 - gas and stormwater pits installation complete, stone benches and fittings to be installed soon.
17.02.2022 - stone benches and fittings installation complete, BIR shelving installation and painting to start soon.
03.02.2022 - rainwater tanks and legal point of discharge connection complete, fixing stage to complete soon.
17.03.2022 - fixing stage complete and painting works to start in the next few days.
31.03.2022 - painting in progress.
14.04.2022 - painting complete, fireplace installation and electrical fit off in progress.
28.04.2022 - fireplace, electrical & ducted fit offs complete. flooring preparation is in progress.
